City Thameslink train performance data
2005 Dec 02 to 2007 May 29
This data is obtained automatically from here.
The data is actual delay from scheduled departure time, in minutes.

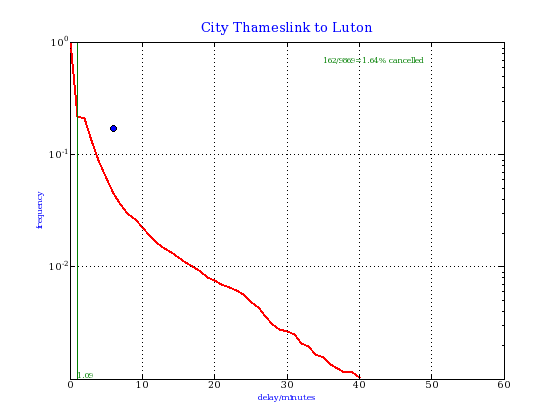

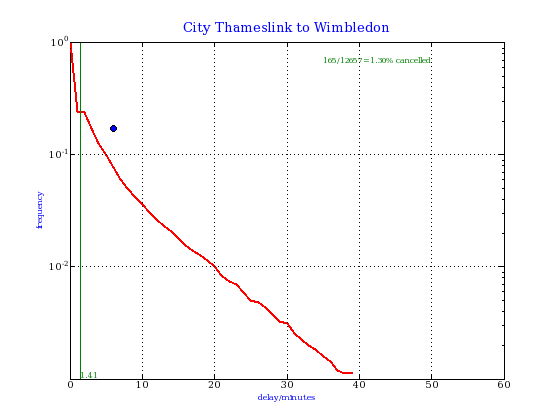

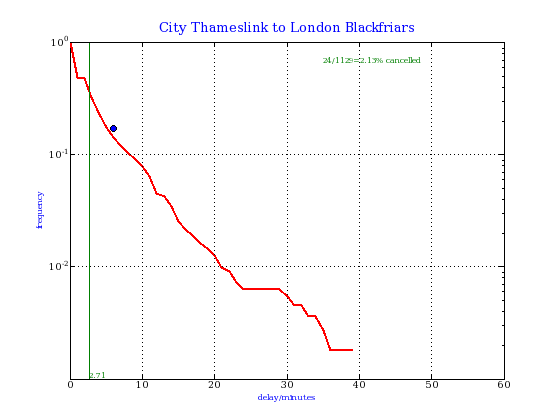

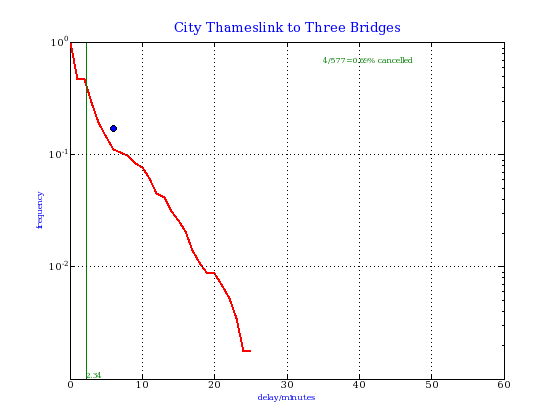

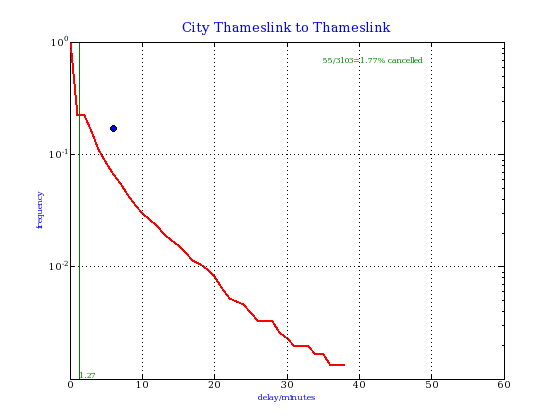

cumulative distributions
These plots allow a prediction of the probability (on the vertical axis) of
departing d minutes or more late. The blue circle represents the
target of 82.8% of trains departing within 5 minutes of schedule; that is,
less than 17.2% delayed 6 or more minutes. If the red curve is under the
blue circle, the target is met. The green vertical line denotes the average
delay. Cancelled trains are ignored in these plots.
